Updated August 31, 2026. A commercial roof leak is not a safe do-it-yourself repair. The practical job for an owner or facility manager is to protect people, limit interior exposure without creating new hazards, preserve evidence, and give qualified contractors the information they need to diagnose the roof assembly.
This guide explains what happens after the immediate response: how to organize a commercial roof-leak investigation, compare a targeted repair with a larger replacement scope, and coordinate the work around an occupied Bay Area building. If water is entering rapidly, a ceiling is sagging, electrical equipment is wet, or conditions appear structurally unsafe, keep people out of the affected area and contact the appropriate emergency and building professionals first. Our separate first-24-hours commercial roof response guide covers that stabilization stage.
Commercial Roof Leak Response at a Glance

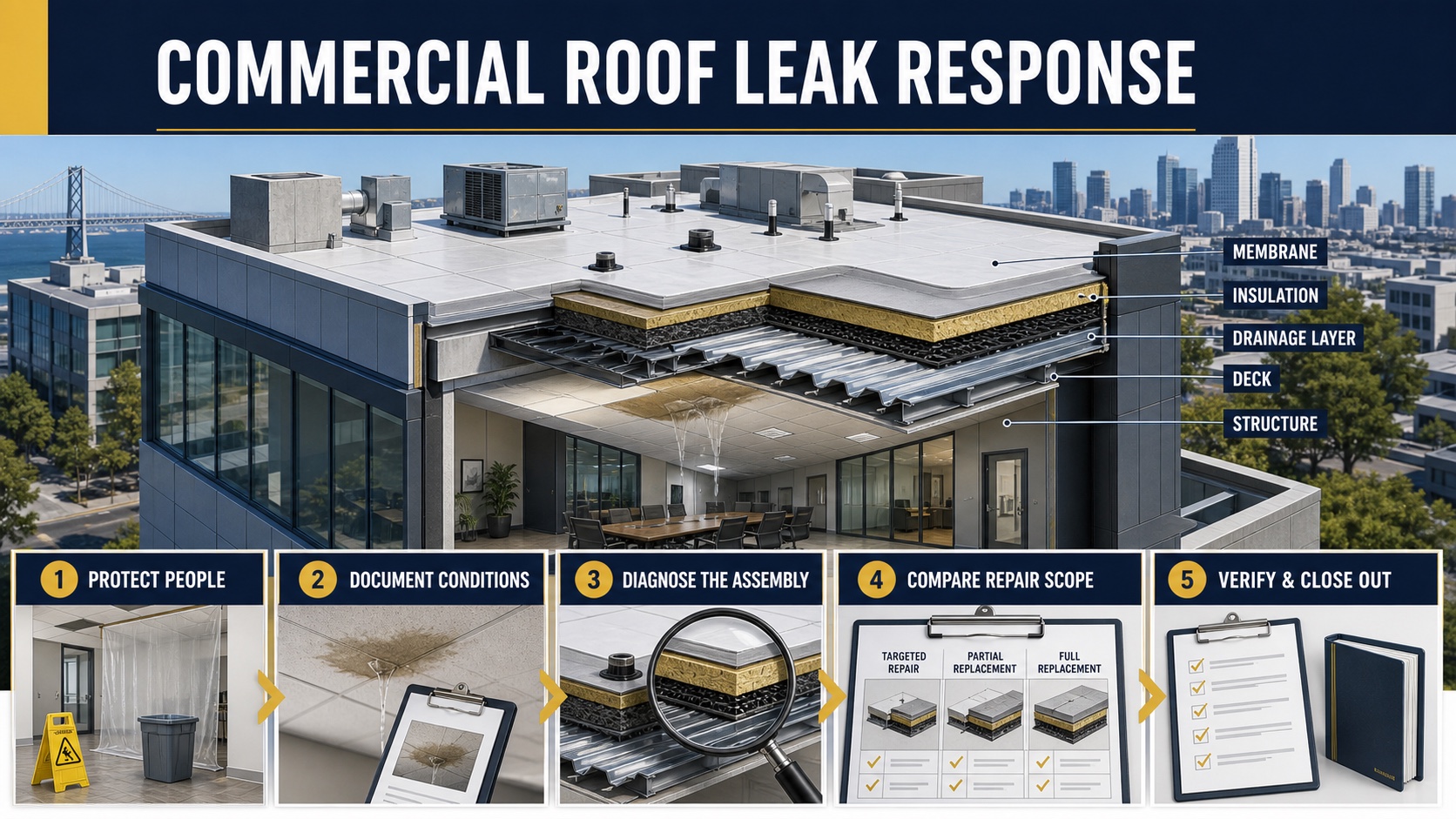

The most reliable sequence is: protect people, document observable conditions, diagnose the complete assembly, compare repair options on the same assumptions, and verify the completed work. The graphic summarizes that sequence; the sections below provide the accessible detail behind it.
1. Protect People and Building Operations
Start with the occupied space, not the roof. Water can travel above ceilings and along deck flutes, framing, conduits and insulation before it becomes visible. The interior drip therefore may not sit directly below the exterior defect.
- Restrict access below active leaks, wet ceiling systems, sagging finishes and affected electrical equipment.
- Use the building’s established emergency contacts for electrical, structural, fire-alarm or life-safety concerns.
- Move movable inventory and equipment only when it can be done safely. Do not disturb materials that may require environmental assessment.
- Do not send untrained staff onto the roof. OSHA has specific fall-protection requirements for work on low-slope roofs because an apparently flat commercial roof is still a fall hazard.
Interior buckets, barriers or protective sheeting may help limit exposure when they can be placed safely, but they are containment measures—not a roof repair. Avoid directing water toward electrical equipment, occupied paths, elevators or other building systems.
2. Build a Useful Condition Record
A contractor can respond more efficiently when the owner provides a concise, time-stamped record instead of a general statement that “the roof leaks.” Record only what can be observed safely.
- Date and time the leak was first observed, recent weather and whether the flow is increasing or decreasing.
- Interior room, grid line, suite or equipment location; wide photos establish context and close photos show the condition.
- Known roof type, approximate installation date, warranty provider and prior repair history.
- Nearby rooftop equipment, drains, penetrations or recent work—but do not assume one of them is the source.
- Impacted ceiling tile, insulation, finishes, inventory and building systems.
- Actions already taken, people contacted and areas placed out of service.
Preserve relevant maintenance logs, roof plans, warranties, product information and contractor reports. If an insurance claim may be involved, follow the policy and carrier’s instructions; coverage and documentation requirements are policy-specific.
3. Diagnose the Roof Assembly, Not Just the Drip
A durable scope depends on finding both the water-entry path and the extent of affected materials. A qualified investigation may review membrane seams, flashing, parapets, penetrations, drains, scuppers, rooftop equipment interfaces, expansion joints and transitions between roof areas. It may also evaluate moisture below the visible surface.
The investigation method should fit the roof system and risk. Visual inspection may be enough for an obvious isolated defect. Other conditions may call for controlled test cuts, moisture mapping, infrared evaluation under suitable conditions, flood testing where appropriate, or review by a design professional. Ask the team to explain what each test can and cannot establish.
Do not treat a surface coating or sealant as a diagnosis. If insulation, cover board or deck materials are wet or damaged, covering the surface can conceal the condition and complicate later work. The repair proposal should state how affected materials were identified and what will be removed, dried, retained or replaced.
Common Leak Paths in Commercial Buildings
The actual cause varies by roof system, age, detailing and recent building activity. Frequent investigation points include:
- Open seams, punctures or damaged areas in single-ply membranes.
- Deteriorated flashing at parapets, curbs, pipes, drains and roof edges.
- Blocked drainage or ponding that exposes weak details for longer periods.
- Movement at expansion joints or transitions between dissimilar assemblies.
- Damage caused by service access, dropped tools or later rooftop equipment work.
- Failed sealants used as part of a designed detail—not simply any aged caulk visible from the ground.
- Condensation or plumbing/HVAC sources that resemble a roof leak.
Commercial roofs include different systems and compatible repair materials. See our overview of commercial roofing material types for owner-level context, but require the proposed repair to match the actual manufacturer, assembly and warranty conditions at your building.
4. Compare Targeted Repair, Partial Replacement and Full Replacement
The best option is not automatically the least expensive first proposal or the largest scope. Owners need comparable assumptions, evidence and exclusions.
| Decision factor | Targeted repair | Partial replacement | Full replacement |
|---|---|---|---|
| Typical evidence | Isolated, confirmed defect with limited affected materials | Damage or wet materials concentrated in a defined roof area | Widespread deterioration, repeated failures or assembly-wide constraints |
| Scope must identify | Exact defect, compatible materials and tie-in detail | Limits of removal, transitions, drainage and retained assembly | Complete assembly, insulation, drainage, edges, penetrations and phasing |
| Owner risk to resolve | A symptom is patched while concealed damage remains | New and existing areas do not integrate or carry compatible warranties | Operational disruption, procurement, permits and unknown deck conditions |
| Closeout evidence | Photos, repair location and product record | Area plan, concealed-condition photos, transitions and warranty terms | Approved scope, inspections, warranties, maintenance requirements and record documents |
A commercial roof replacement deserves a separate capital-project review. Replacement can affect rooftop equipment, curbs, drainage, insulation, structural loading, energy requirements, occupied operations and permit inspections; those interfaces are easy to miss when proposals are compared only by roof area and price.
Questions Every Repair Proposal Should Answer
- What evidence identifies the leak source? Ask for marked photographs, plan locations or test results.
- What materials are affected? Separate the visible membrane defect from wet insulation, cover board, deck, ceilings or interior finishes.
- What is included and excluded? Clarify access, protection, demolition, disposal, temporary drying, hazardous-material testing, electrical work, interior restoration and after-hours work.
- How will the repair integrate with the existing roof? Identify compatible products, manufacturer requirements and warranty implications.
- What happens if concealed damage is found? Define documentation, authorization and pricing procedures before opening the assembly.
- What permits and inspections apply? Requirements vary by jurisdiction and scope. San Francisco, for example, has a specific process for reroofing permit inspections after a permit is issued.
- How will completion be verified? Establish inspection, photo, testing, punch-list and closeout expectations.
California Contractor and Permit Checks
Before award, confirm the contractor’s current status and classifications through the CSLB license-check service. CSLB defines a C-39 Roofing Contractor as one who installs and repairs roof surfaces that seal, waterproof and weatherproof structures. CSLB also explains circumstances in which a General Building contractor may hold a prime contract and subcontract specialty roofing work to an appropriately licensed C-39 contractor. The right contracting structure depends on the complete project scope.
Permit and inspection requirements are also scope- and jurisdiction-specific. Confirm them with the local authority before work begins. In San Francisco, the Department of Building Inspection includes reroofing in its permit-inspection process; a contractor’s statement that a permit is unnecessary should be verified against the actual scope and current city requirements.
Coordinate the Repair Around an Occupied Building
For an operating office, retail, medical, industrial or multi-tenant property, the roof scope is only one part of the plan. The owner and project team may need to coordinate:
- Tenant notices, restricted areas, after-hours work and noise or odor controls.
- Protection of equipment, inventory, ceilings and public paths.
- Temporary shutdowns or protection for HVAC, electrical, fire-alarm and communications systems.
- Crane, hoisting, loading, parking, street-use and delivery constraints.
- Weather criteria for opening and closing the roof assembly each day.
- Daily photos and sign-off before concealed work is covered.
This is where commercial preconstruction and general-contractor coordination can add value when the roof work is part of a larger, multi-trade renovation. The role should be defined honestly: dedicated roof diagnosis and installation should be performed by appropriately qualified roofing professionals, while the broader team coordinates building systems, tenants, permits, logistics and interior restoration.
5. Verify and Close Out the Work
A dry ceiling immediately after repair is encouraging, but it is not a complete closeout record. Before final acceptance, confirm:
- The documented defect and agreed repair limits were addressed.
- Concealed conditions and any scope changes were photographed and approved.
- Drainage paths, flashings, penetrations and transitions were left complete.
- Required permit inspections and manufacturer or consultant observations were completed.
- Warranty documents identify the responsible party, covered area, term, exclusions and maintenance obligations.
- The owner receives product data, before-and-after photos, repair locations and recommended inspection dates.
The U.S. Environmental Protection Agency advises responding quickly to water-damaged materials and provides commercial-building guidance for drying clean-water damage within 24 to 48 hours to help prevent mold growth. That timing is a moisture-response target, not proof that every material can be retained; contaminated water, suspected mold, hazardous materials or extensive damage require qualified assessment.
Prevent the Next Leak from Becoming Another Emergency
Turn the repair record into a maintenance baseline. Keep a roof plan showing drains, penetrations, equipment and repair locations. Log who accesses the roof and why. Review the roof after major weather events and after work by HVAC, electrical or communications trades. Clean and inspect drainage components on a schedule appropriate to the building and surrounding conditions. Follow the roof manufacturer and warranty provider’s written maintenance requirements rather than relying on a universal inspection interval.
Frequently Asked Questions
Can a facility manager patch a commercial roof leak?
Facility staff should not perform roof repair unless they are trained, authorized, protected from falls and working within all applicable licensing and safety requirements. Interior containment that can be performed safely is different from accessing, cutting, heating, sealing or altering the roof assembly.
Why can the leak source be far from the ceiling stain?
Water can travel along the underside of the deck, structural members, insulation, conduits or sloped surfaces before it becomes visible. Diagnosis should trace the assembly and confirm the entry path instead of patching directly above the interior stain.
Does one leak mean the entire roof needs replacement?
No. An isolated, confirmed defect may support a targeted repair. Repeated leaks, widespread wet materials, deteriorated components, incompatible prior repairs or assembly-wide limitations may support a larger scope. The decision should follow documented conditions rather than a rule based only on roof age.
How much does commercial roof-leak repair cost?
A responsible estimate requires the roof system, access, defect, affected layers, safety provisions, permits, logistics and interior impacts. A universal per-square-foot number can be misleading for leak investigation and localized repair. Compare written scopes on common assumptions and define how concealed conditions will be priced.
When should a general contractor be involved?
A commercial general contractor can be useful when the work crosses multiple trades or affects occupied operations, rooftop equipment, structural components, interiors, permits and tenant logistics. A standalone roof repair still requires the appropriate roofing qualifications and contracting structure.
Planning a Roof-Related Commercial Project
Constructive Solutions is a Bay Area commercial general contractor. When roof work is one component of a broader renovation or multi-trade project, our team can help define interfaces, logistics, documentation and coordination with appropriately qualified specialty contractors. We do not present this article as a promise of 24-hour emergency roofing service. For a project-specific discussion, use our commercial construction contact page and describe the building, location, current condition and larger project scope.
Authoritative References
- OSHA: Duty to provide fall protection, including low-slope roof work
- U.S. EPA: Water Damage—Cleanup and Mold Prevention in Schools and Commercial Buildings
- California CSLB: C-39 Roofing Contractor classification
- California CSLB: Building Official Information Guide
- San Francisco DBI: permit inspections, including reroofing
Constructive Solutions, Inc. is a full-service commercial construction company serving San Francisco and Bay Area.
