A preconstruction communication plan should do more than schedule meetings. It should show how the owner, design team and contractor will record assumptions, assign decisions, route questions, evaluate cost and schedule effects, distribute approved direction and verify that the current information reached the people doing the work.
From the contractor side of the table, we see communication problems develop when a project has activity but no shared control system. Emails, meeting notes, drawings, estimates and verbal direction may all exist, yet the team cannot answer three basic questions: What is current? Who must decide? What does the decision affect?
Begin With a Communication Charter
Before design and pricing accelerate, document how the team will communicate. The charter can be concise, but it should identify the owner representative, design leads, contractor leads, property-management contact and other parties who can provide information or approve decisions. It should also define the official document platform and which conversations require a written record.
A useful charter distinguishes coordination from authorization. A project manager may coordinate a question without having authority to approve added cost. A property manager may approve an access window without changing the design. A superintendent may identify a field conflict without determining the design solution. Clear roles prevent a helpful conversation from being mistaken for contractual direction.
Build a Responsibility and Decision Matrix
List recurring decision types and assign who prepares, reviews, recommends and approves each one. Typical categories include scope, design, budget, schedule, property rules, shutdowns, long-lead procurement, tenant operations and closeout. The matrix should follow the actual agreements; it does not create authority that a party does not have.
| Decision type | Information needed | Responsible response | Record |
|---|---|---|---|
| Scope clarification | Current drawings, narrative and field condition | Design/owner direction under the project agreements | RFI response or bulletin |
| Budget decision | Scope, estimate basis, alternatives and timing | Authorized owner representative | Decision log and estimate revision |
| Schedule decision | Dependency, procurement and operational effect | Assigned project decision-maker | Updated milestone or schedule narrative |
| Site logistics | Access, occupants, shutdowns and building rules | Owner/property/contractor coordination | Approved logistics plan |
| Change authorization | Defined scope, cost and schedule effect | Party authorized by the contract | Executed change record |
Maintain One Decision Log
A decision log is different from meeting minutes. Minutes summarize discussion; the decision log isolates items that can affect scope, price, schedule, approvals or operations. Each item should have an owner, due date, current status, supporting reference and final disposition.
We recommend recording the date by which a decision is needed—not merely the date someone hopes to answer. Connect that date to the downstream event: design release, permit submission, trade pricing, material order, shutdown notice or mobilization. This helps the owner see the consequence of delayed direction without presenting a forecast as a guarantee.
Route RFIs and Design Questions Deliberately
A request for information should identify a specific conflict, omission or clarification need and cite the documents involved. The contractor can describe the construction issue and, where appropriate, suggest a practical option. The responsible design professional retains the design role, and the authority having jurisdiction retains approval authority.
Define who may submit an RFI, who reviews it before issue, who receives it and how the answer is incorporated into current documents. Avoid parallel answers in email, text messages and meeting notes. If an urgent conversation occurs, capture the outcome through the established record.
Connect Communication to Cost and Schedule
Not every clarification changes cost or time, but the team needs a consistent method to check. When new direction arrives, ask whether it changes quantities, systems, access, sequence, procurement, testing, inspection or owner-furnished work. If the effect is not yet known, label it pending rather than zero.
Estimate and schedule updates should reference the decisions that caused them. This creates an audit trail and helps the owner compare the current plan with earlier assumptions. It also prevents a superseded estimate from continuing to circulate as if it were current.
Control Versions and Distribution
Choose one location for current drawings, specifications, addenda, estimates, schedules and logs. Establish naming, revision and superseded-document conventions. A transmittal should identify what changed and who received it. Field teams and pricing partners should not have to decide which attachment in a long email chain is current.
For complex projects, the owner may define digital-information requirements before the team develops its execution plan. The National Institute of Building Sciences’ NBIMS-US guidance reinforces the principle that owner information requirements and delivery expectations should be established deliberately rather than assumed.
Plan Communication for Occupied and Multiemployer Sites
Occupied commercial work needs a separate operational communication path. Identify who issues notices about access, noise, dust, odor, deliveries, elevator use, utility interruptions and emergency procedures. State how much notice is required and who confirms that affected occupants received it.
OSHA’s recommended practices emphasize communication and coordination between host employers, contractors and other employers at shared worksites, including exchanging hazard information before work starts and when conditions change. Project-specific safety responsibilities belong in the applicable plans and agreements; a meeting calendar alone is not a safety program.
Use Meetings to Close Decisions
Every recurring meeting should have a purpose, owner and output. A design-coordination meeting may close RFIs and interfaces. An owner meeting may resolve budget and operational decisions. A trade meeting may address sequencing and constructability. Repeating the same open item in several meetings without one accountable owner creates noise rather than progress.
| Meeting | Primary output | What should not remain ambiguous |
|---|---|---|
| Owner/preconstruction | Approved decisions and priority changes | Authority, due dates and budget basis |
| Design coordination | Closed questions and current design direction | Responsible discipline and document revision |
| Estimate review | Reconciled scope, allowances and alternates | Included work and unresolved assumptions |
| Logistics review | Access, phasing, shutdown and protection plan | Property and occupant responsibilities |
| Readiness gate | Proceed, hold or proceed with listed conditions | Open risks and accountable owners |
What Owners Should Receive
At the end of a preconstruction stage, the communication system should leave the owner with usable records: the current decision log, responsibility matrix, RFI status, estimate basis, schedule assumptions, risk register, logistics plan and list of unresolved items. These documents do not eliminate uncertainty. They make uncertainty visible and assign the next action.

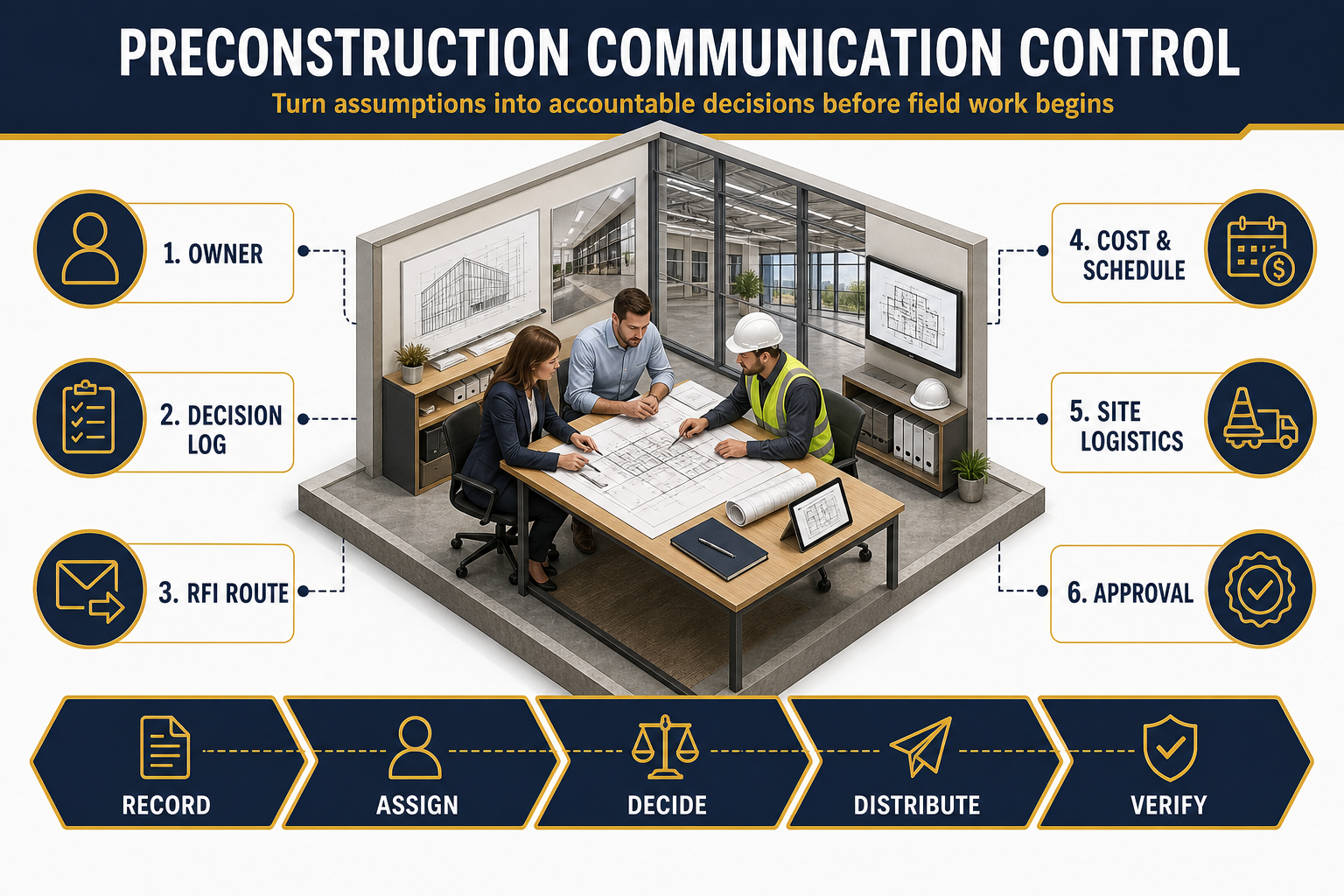

The accompanying infographic summarizes the control loop: record, assign, decide, distribute and verify. Its six checkpoints—owner, decision log, RFI route, cost and schedule, site logistics and approval—should be adapted to the project’s agreements and responsible parties.
Frequently Asked Questions
Is a decision log the same as meeting minutes?
No. Minutes record discussion and actions from a meeting. A decision log tracks project decisions across meetings and documents, including responsibility, due date, status and final disposition.
Who should approve a preconstruction decision?
The agreements and owner governance process determine authority. The communication plan should identify the person authorized for each decision category without shifting professional, contractual or regulatory responsibility.
Does better communication prevent all changes?
No. Existing conditions, design development, agency review and owner needs can still change. A good system helps the team identify, evaluate and authorize changes through a traceable process.
When should the communication plan begin?
As soon as multiple parties begin exchanging project information. It should be refined as the team, delivery method and agreements become defined.
Review our commercial preconstruction services, or share the property, scope and current project stage for a practical discussion.
Primary Sources Reviewed
Constructive Solutions, Inc. is a full-service commercial construction company serving San Francisco and Bay Area.
Whatever your vision, we have the resources, experience, and insight to make your concept a reality, and a space where your business can flourish.
Call Us Now for Estimate











I loved how you mentioned that site analysis can make sure that construction sites fulfill project requirements. My brother is wanting to start a construction company and he was wondering how he could make sure the site can fulfill all the requirements. I’ll be sure to tell him that he should consider site analysis for his future construction projects.
Love what you said about “Pre-construction Services: Closing Gaps in the Communication Loop”
thanks for sharing this article, I liked it and enjoyed this article very much.
keep sharing more articles like this.
cheers!!!
