A ground-up commercial project starts with an empty or substantially cleared site, but construction is not the first decision. The owner must first confirm that the business program, property, approvals, utilities, budget, delivery strategy and team can support the proposed building. That early alignment is what turns new commercial construction from an attractive concept into an executable project.
In our work as a Bay Area commercial general contractor, we see the best decisions happen when owners treat the project as a sequence of evidence-based gates. Each gate should answer a defined question before the team authorizes the next level of design, procurement or field work. The process below is an owner-focused framework—not a promise that every jurisdiction, property or building type will follow the same timeline.
What ground-up commercial construction includes
Ground-up construction creates a new building and its supporting site infrastructure. The work may include demolition or clearing, earthwork, underground utilities, foundations, structure, enclosure, mechanical and electrical systems, interiors, life-safety systems, landscaping, paving, testing and closeout. The precise scope depends on the site, occupancy, local conditions and the owner’s operational requirements.
This is different from a renovation or tenant improvement, where an existing structure and many existing systems constrain the work. A ground-up project offers more design freedom, but it also carries broader entitlement, site, utility, civil, geotechnical and environmental questions. Owners comparing the two paths can review our ground-up versus renovation decision guide.

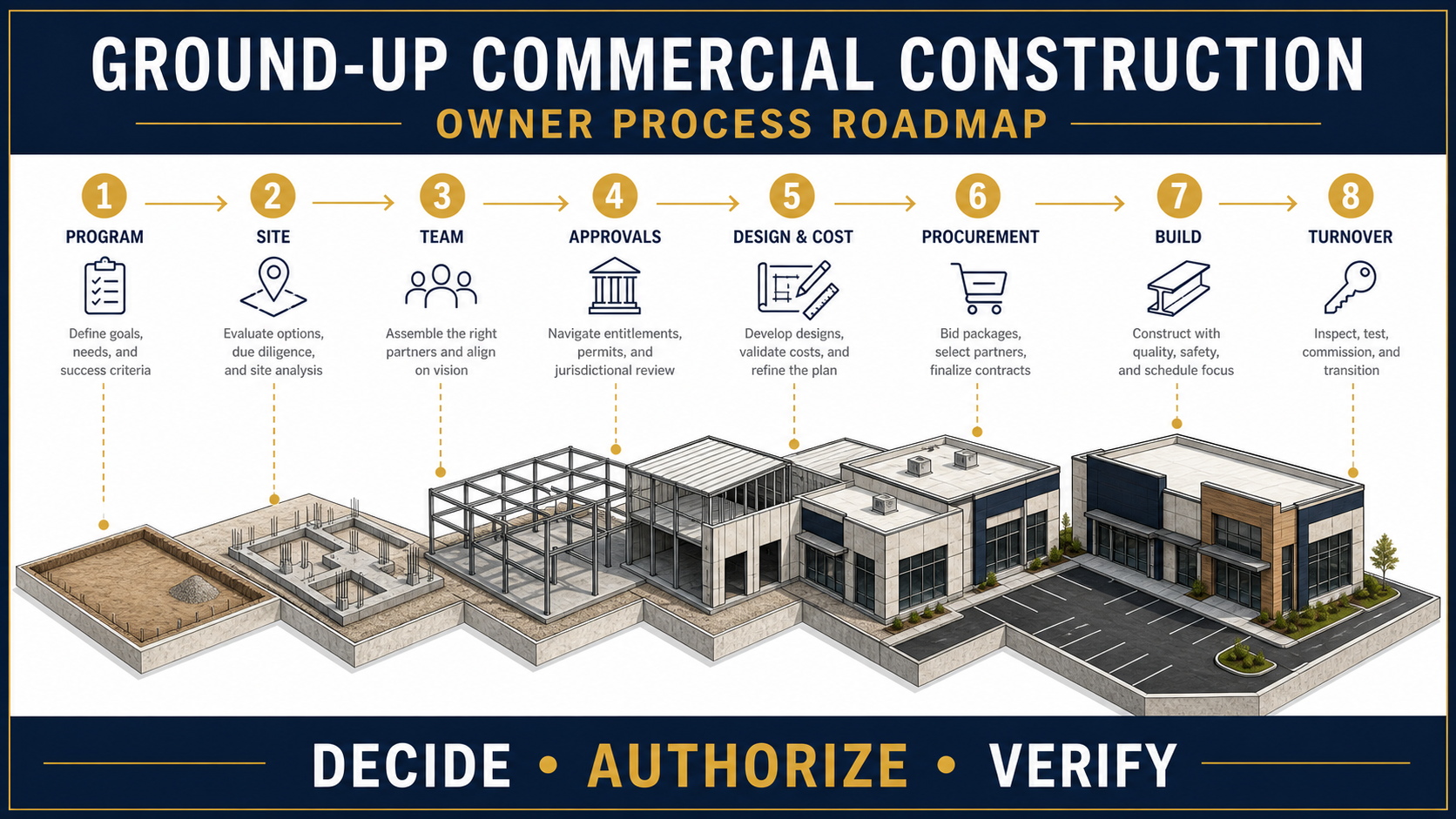

The ground-up construction process: eight owner gates
| Gate | Owner question | Evidence to review |
|---|---|---|
| 1. Program | What must the completed property support? | Uses, capacity, adjacencies, performance needs, budget boundary and decision authority |
| 2. Site | Can this property support the program? | Title and survey, zoning, access, geotechnical conditions, utilities, environmental constraints and easements |
| 3. Team | Who owns each decision and deliverable? | Delivery method, responsibility matrix, consultant scope, insurance and licensing |
| 4. Approvals | What must agencies approve, and in what order? | Entitlements, environmental review, building and trade permits, utility reviews and agency dependencies |
| 5. Design and cost | Is the design coordinated and financially supportable? | Basis of design, estimate assumptions, alternates, value analysis, schedule and risk register |
| 6. Procurement | What must be released before field work? | Bid packages, long-lead log, approved substitutions, submittal schedule and buyout status |
| 7. Build | Is installed work matching approved documents? | Inspections, RFIs, submittals, testing, change records, safety controls and progress reporting |
| 8. Turnover | Can the owner safely occupy and operate the building? | Agency sign-offs, commissioning, training, warranties, record documents and open-item ownership |
1. Define the business program before drawing the building
Begin with the operation the facility must support. Document occupancy, headcount or customer capacity, equipment, loading, storage, security, accessibility, technology, power, ventilation, water, acoustic and future-growth needs. Identify what is required, what is preferred and what could be deferred. A clear program gives the architect, engineers and contractor a shared basis for evaluating options.
The owner should also establish decision authority. Who can approve scope, budget, finishes and changes? Who represents facilities, operations, finance, leasing and executive leadership? Unresolved internal decisions can affect a project as much as an external approval.
2. Test the site before relying on the concept
A promising address is not yet a buildable plan. The due-diligence team may need to review land-use controls, parcel boundaries, legal access, easements, existing utilities, utility capacity, topography, drainage, geotechnical conditions, environmental history, flood or wildfire exposure, protected resources and demolition requirements. The appropriate investigations vary by property; legal, environmental and engineering professionals should advise within their disciplines.
California’s Construction Stormwater Program, for example, generally requires permit coverage when a project disturbs one or more acres of soil, including a smaller project that is part of a larger common plan reaching that threshold. That is one reason civil, grading and stormwater questions belong in early planning rather than after mobilization. Our commercial site-selection guide provides a more detailed due-diligence checklist.
3. Choose the delivery strategy and define responsibilities
The owner should select the delivery method based on project constraints—not a generic claim that one method is always faster or cheaper. Design-bid-build, design-build and construction-manager-led approaches distribute design, pricing and coordination responsibilities differently. The agreement structure, risk allocation and procurement rules should be reviewed with qualified legal and insurance advisers.
Regardless of delivery method, create a responsibility matrix covering design criteria, agency communication, utility coordination, estimating, constructability, scheduling, procurement, testing, commissioning, closeout and owner-furnished equipment. Our commercial preconstruction services explain how early contractor input can connect those workstreams before field execution.
4. Map entitlements, permits and utility approvals
Ground-up approval paths are property- and jurisdiction-specific. In San Francisco, the Project Application is used to collect information for environmental evaluation, Planning Code compliance and General Plan conformity; where it is required, review does not begin until the application and supporting materials are accepted as complete. Other Bay Area jurisdictions use their own processes, departments and sequencing.
Build an approvals matrix that names every anticipated review, submission owner, prerequisite and open question. Include planning or land-use action, environmental review, building and trade permits, fire review, public works, utilities and any health-care or other occupancy-specific agency. The applicable code edition should be confirmed with the design team and authority having jurisdiction. The 2025 California Building Standards Code became effective January 1, 2026, but local amendments and the permit-submittal date still matter.
For a closer look at this workflow, see our ground-up commercial permitting roadmap.
5. Advance design, estimate and schedule together
A useful estimate is tied to the information available when it is prepared. At each design milestone, the team should record quantities, unit assumptions, exclusions, allowances, escalation basis, alternates and unresolved risks. Comparing only bottom-line numbers can hide material differences in scope.
At the same time, update the schedule using real approval, design, procurement and construction logic. Site conditions, utility lead times, agency review, specialized equipment, seasonal work and long-lead materials can be critical drivers. There is no responsible universal duration for ground-up construction. The right question is whether the schedule states its assumptions and whether the team has identified what could move the critical path.
Value engineering should protect required performance while evaluating alternatives; it should not be shorthand for selecting the cheapest material.
6. Procure deliberately and establish field readiness
Before mobilization, confirm permit status, site access, temporary utilities, survey control, erosion and sediment controls, logistics, public protection, testing responsibilities and the release status of long-lead items. The contractor’s site-specific safety program is separate from the owner’s business decisions and must be developed and administered by the responsible employers and competent personnel.
Procurement should follow coordinated documents and an agreed submittal process. Early release may be appropriate for utilities, structural systems, switchgear, elevators or specialized equipment, but it also commits the owner before later design is complete. Each release should state the design basis, interfaces, commercial terms and change exposure.
7. Control field execution with current information
During construction, the owner needs a reliable view of progress and decisions—not every detail of daily trade supervision. A practical reporting cadence covers schedule status, procurement, inspections, RFIs, submittals, changes, safety, quality observations, constraints and decisions due from the owner.
Payments and changes should be tied to documented scope. The team should maintain one current set of approved documents and make responsibility for distributing revisions explicit. For concealed work, testing and inspection records matter because many systems cannot be fully evaluated after finishes are installed.
8. Plan occupancy and closeout before the end
Turnover is a process, not a final-day handoff. Identify required agency inspections, functional testing, commissioning, owner training, spare parts, warranties, operations manuals, record drawings, equipment data and access credentials early enough to collect them during the work.
Separate items required for lawful and safe occupancy from minor completion items. Assign an owner and deadline to every open item. The facilities team should receive usable information in a searchable structure, not an unorganized file dump.
Owner questions before authorizing the next phase
- Is the business program approved, and are required versus optional elements clear?
- Which site assumptions have been verified by survey, engineering or specialist review?
- What approvals and utility actions control the schedule?
- Does the current estimate state scope, exclusions, allowances and uncertainty?
- Which owner decisions are due before the next design or procurement release?
- How will changes, testing, commissioning and closeout be documented?
Frequently asked questions
When should a commercial contractor join a ground-up project?
The best timing depends on the delivery method, but contractor input can be valuable while the owner and design team are still testing site logistics, constructability, estimate assumptions, phasing and procurement. Early involvement does not replace the architect, engineers or authority reviews.
How long does ground-up commercial construction take?
There is no universal duration. Entitlements, environmental review, design complexity, utilities, permits, site conditions, procurement and building systems can all affect the schedule. Request a project-specific schedule that identifies assumptions, dependencies and decision dates.
How should an owner compare ground-up proposals?
Normalize scope before comparing price. Review drawings and specifications used, allowances, exclusions, alternates, schedule assumptions, staffing, insurance, licensing, testing, closeout and responsibility for coordination. A low total with important omissions is not a reliable comparison.
What should be complete before construction starts?
The exact readiness gate varies, but owners should understand permit status, financing authorization, approved scope, site access, utility strategy, early procurement, insurance, logistics, testing responsibilities and unresolved risks before authorizing mobilization.
